In this edition we will discuss the Progress of the 150 kV Teluk Ratai Substation Development Project located in Pesawaran city and Ext 2 LB 150 kV Pagelaran Substation (GI) located in Pringsewu city, Bandar Lampung Province.
The project entrusted by PT PLN (Persero) Southern Sumatra Development Unit (UIP SBS) to PT Rekadaya Elektrika (RE) includes Procurement, Mechanical Electrical Installation and Civil Works. Until the first quarter of 2023, the overall work progress for the construction of GI Teluk Ratai and GI Pagelaran has reached 83.74%.

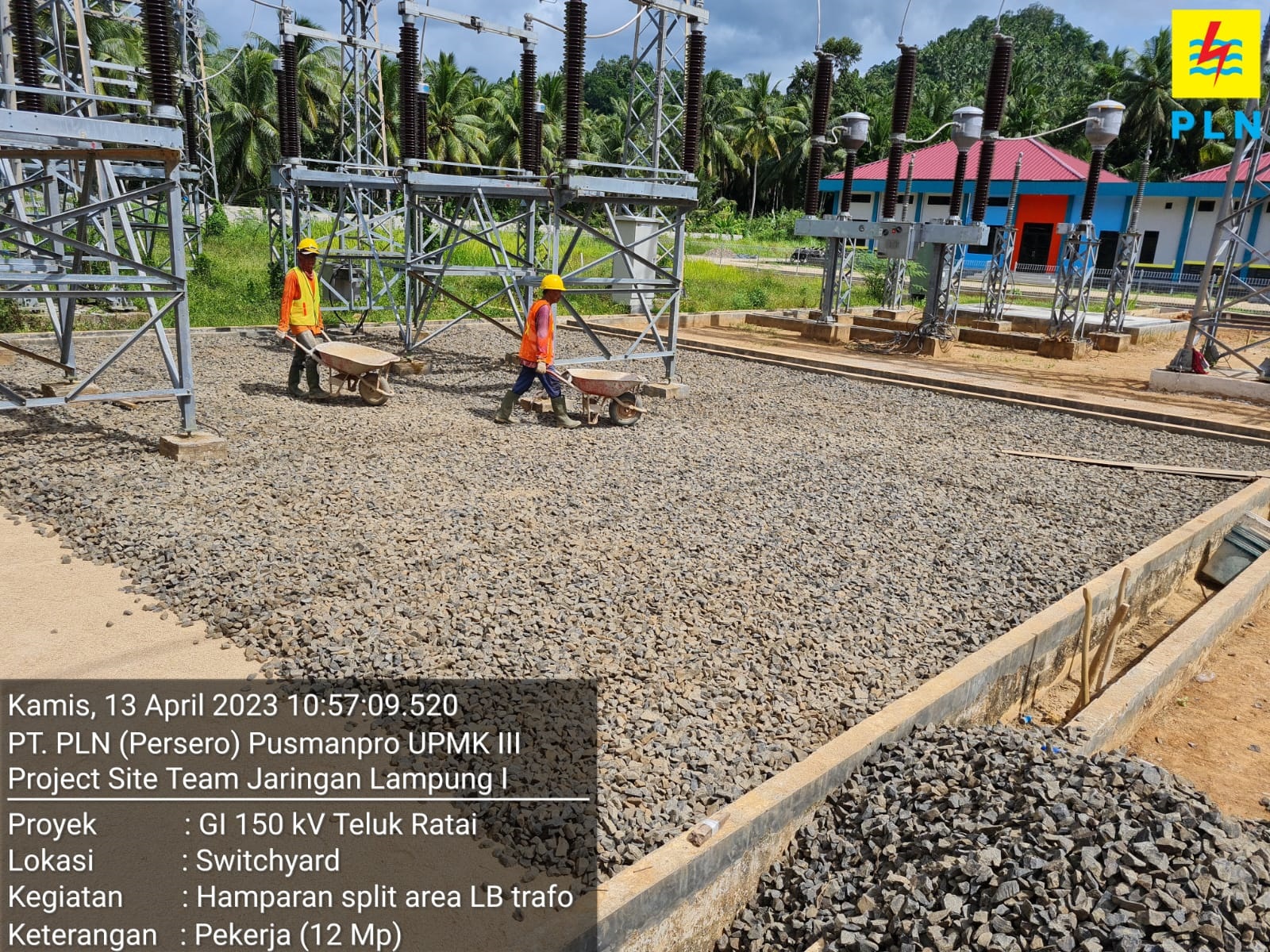

The work that is being completed by the team in the field for GI Teluk Ratai is in the form of switchyard fence work, drainage and control basin work, construction of control buildings and substation area complex road work.
As for GI Pagelaran itself, construction work has been completed 98.5% and is completing electromechanical work, which is carried out in parallel with the preparation of individual tests towards commissioning. Furthermore, waiting for the readiness of the Gedong Tataan Transmission and GI (not carried out by RE), then the plan is to conduct an individual test and be ready to be energized in June.
